Skip to content

Effort Management: Estimated, Actual, and Accepted

In ITM Platform, effort is tracked from estimation to reporting, providing the basis for better planning, cost calculation, and resource management.

The system uses several distinct effort fields—Estimated (assigned and unassigned), Actual, and Accepted—each serving a specific function. This guide provides a detailed explanation of each effort type, including its purpose, where it is managed in the platform, and the roles that can modify it.

1. Estimated Effort (Assigned)

Estimated Effort is the forecast or prediction of the total hours required to complete a task or activity.

The Project Manager usually estimates the assigned effort by allocating a specific number of hours for a user to complete a task. ITM Platform then distributes these hours across the working days between the task’s start and end dates, enabling resource planning and capacity analysis.

What it is used for:

How to Enter Estimated Effort in ITM Platform:

a. From the task: You can add effort directly from the task or activity detail screen. Here’s how:

  1. Go to the project and open the task you want to update.
  2. Go to the Effort tab.
  3. From here, you can assign effort to either a Professional Category (for unassigned planning) or a specific Team Member.
  4. Enter the number of hours in the effort field and save.

b. For multiple tasks at once: You can enter estimated effort for many tasks and team members from the Team tab. Here’s how:

  1. Go to the project or service and open the Team tab.

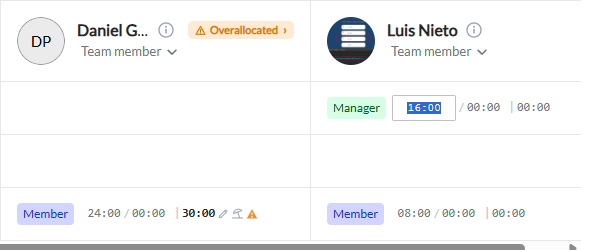

  2. Click the estimated figure of an assignment (the first number in the cell) and type the hours. Press Tab to commit and move to the next assignment.
  3. To assign a task and estimate it in one step, click an empty cell and enter the task role and the estimated time. To assign and estimate many tasks at once, select them and click Assign to user/s.
  4. Click Save.

See Project team management for the full description of the Team tab.

Who can edit it: Project and Service Managers, or users with a Full Access license.

2. Estimated Effort (Unassigned)

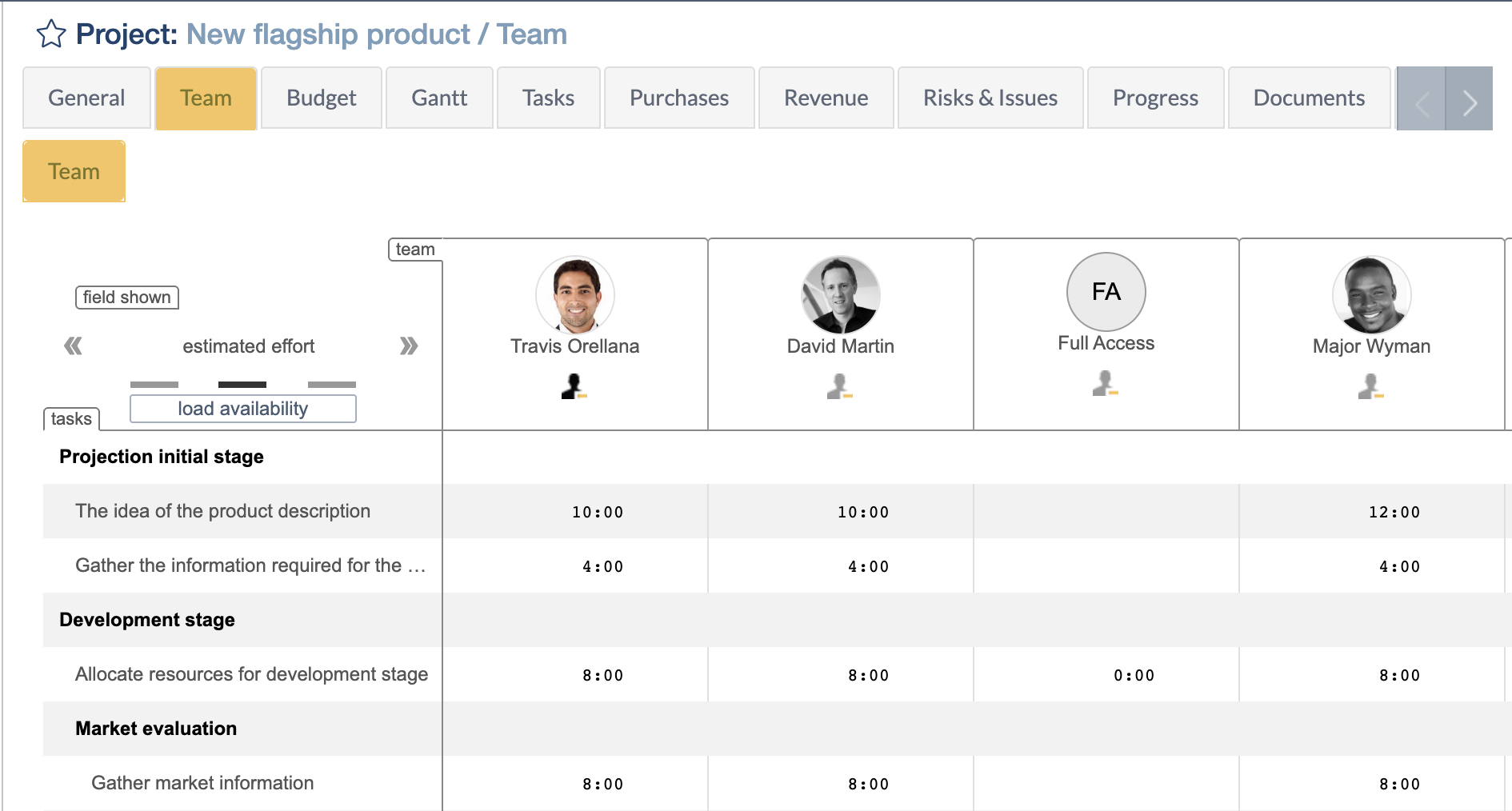

The estimated unassigned effort is planned for a specific professional profile (e.g., "Account Manager") but has not yet been assigned to a named team member. On the Effort tab, found within the task's detail screen, you can define effort by professional category.

A task's total estimated effort is the sum of the effort assigned to people and the unassigned effort of every professional category. Whether assigning hours reduces the unassigned effort depends on where you enter them:

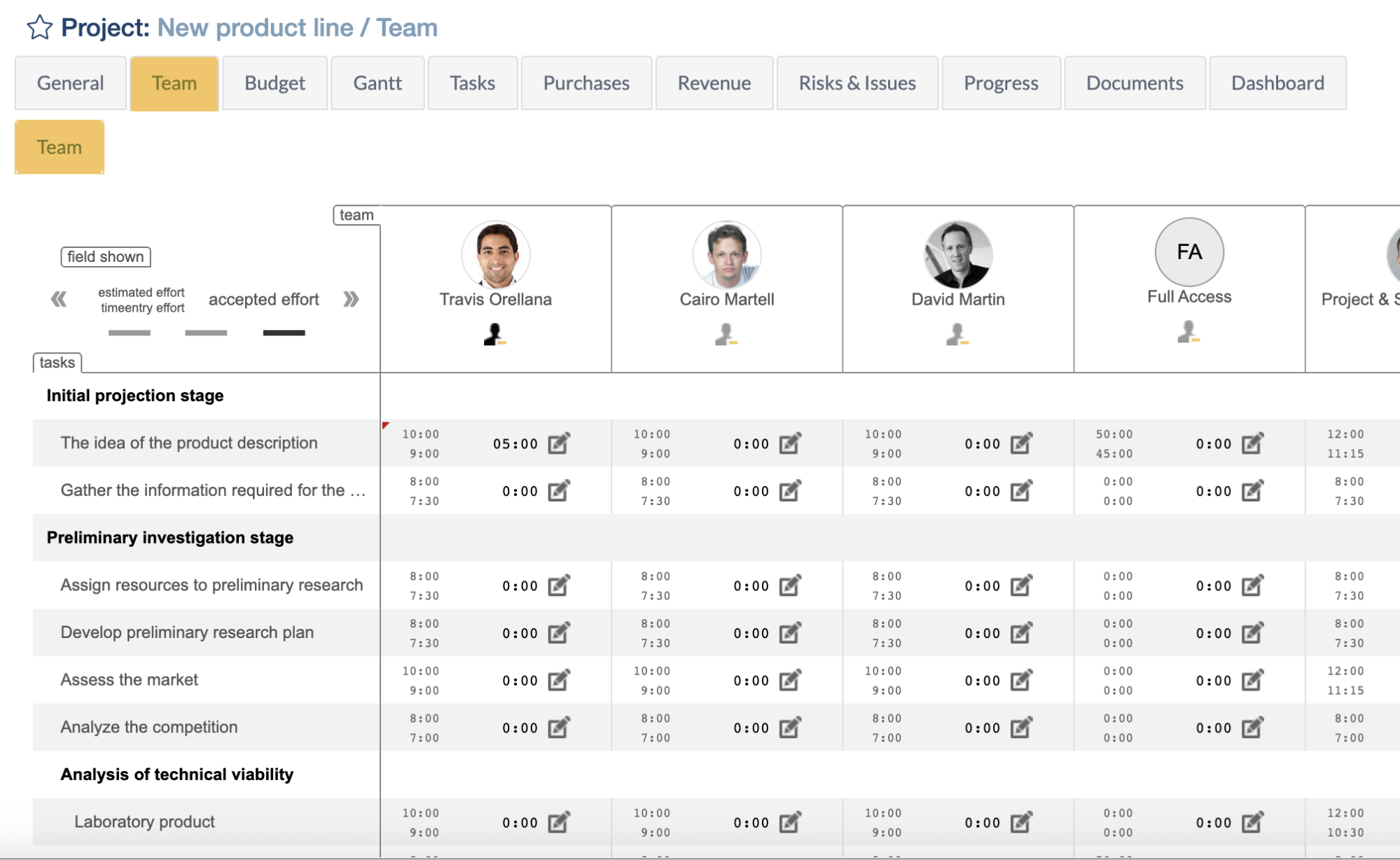

  • Task Effort tab: when you raise the estimate of a team member whose professional category has unassigned effort on the task, that unassigned effort decreases by the same amount and the total stays the same. For example, with 100 unassigned hours for "Account Manager", assigning 40 hours to Jane Doe, an Account Manager, leaves 60 unassigned hours. Lowering her estimate returns the hours to unassigned.
  • Resources > Planning: lowering a person's hours on a task keeps the category's demand, so the hours removed become unassigned effort and the task total does not change. Raising them above the demand raises the task total.
  • Team tab and Gantt: estimates entered there are added to the task total; the unassigned effort stays as it was.

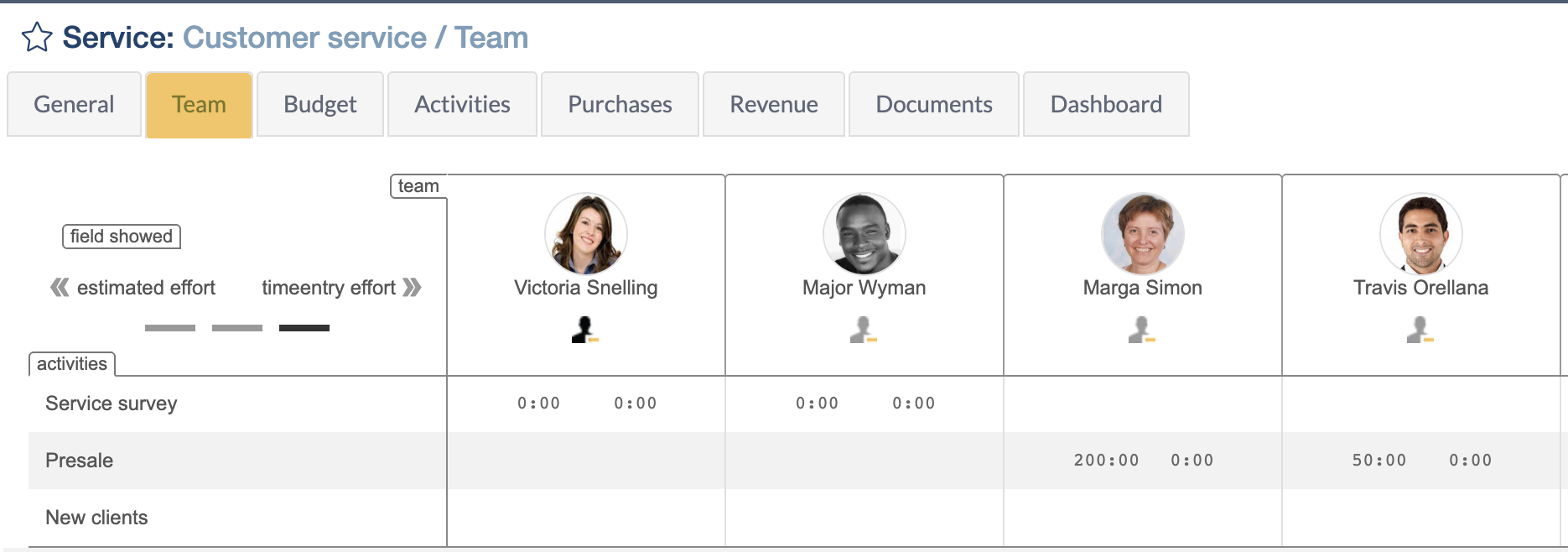

Unassigned effort is shown in the task Effort tab, in Resources > Planning as the gap between demand and allocation, and in Tasks reports (Task Effort Categories > Unassigned Effort). The Team tab and the Gantt do not show it. Kanban projects do not use unassigned effort.

Unassigned effort is distributed across the working days of the task period using the project's Working Hours schedule and Holiday Calendar. If the project has no custom calendar, the account defaults are used.

What it is used for: - Early-stage planning when you know the skills required but not the specific individuals. - Identifying staffing gaps between demand and assigned resources.

How to Enter Unassigned Effort in ITM Platform:

From an individual task: You can add unassigned effort directly from a task's detail screen. Here’s how:

  1. Go to the project/service and open the task/activity you want to update.
  2. Click on the Effort tab.
  3. Add the Professional Category for the role you need (e.g., "Account Manager").

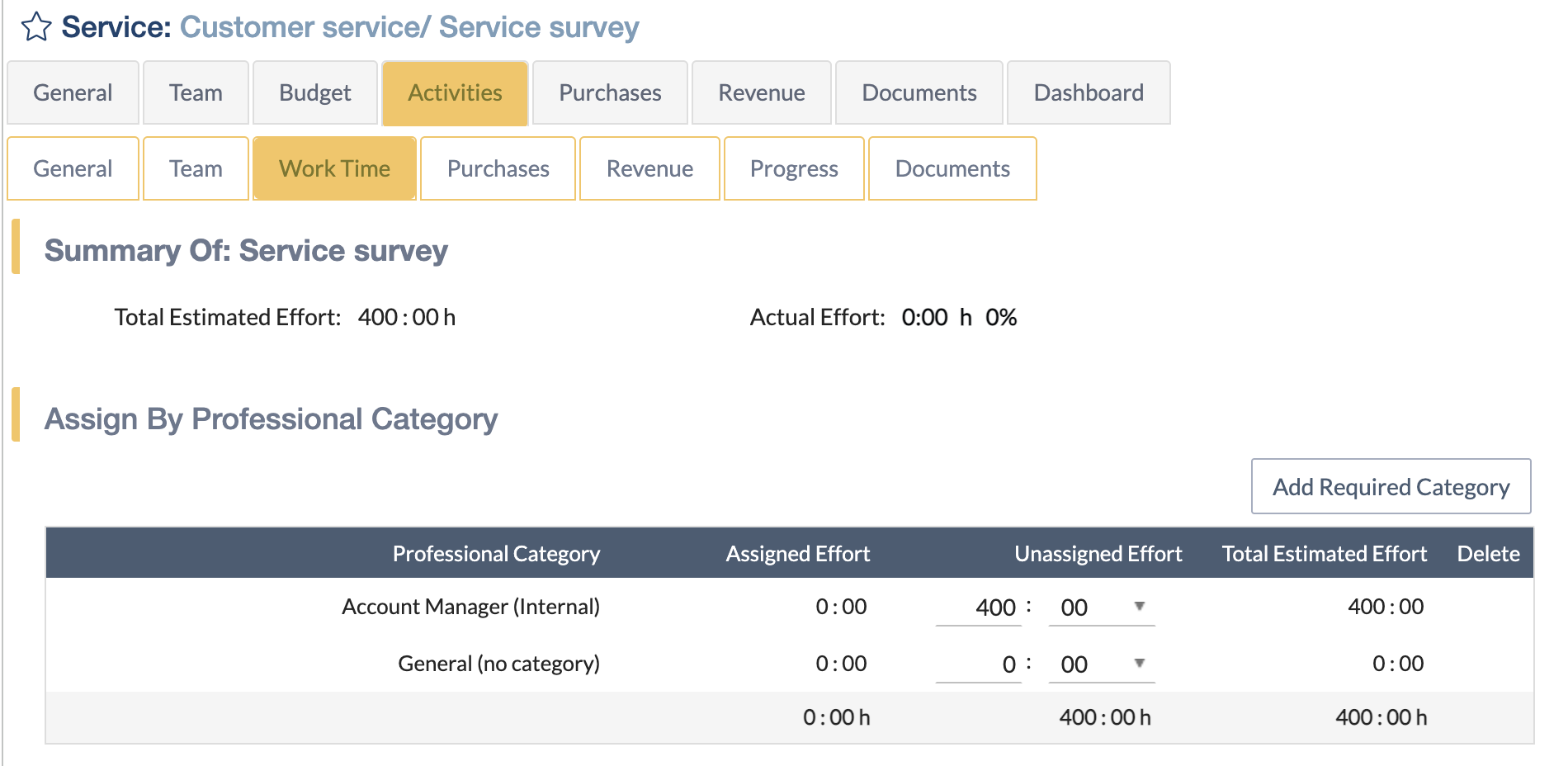

  4. Enter the number of hours in the unassigned effort field for that category.
  5. Click Save.

Who can edit it: Project Managers, Service Managers, or users with a Full Access license.

3. Actual Effort

Actual Effort represents the actual time that team members have reported working on a specific task or activity. It is the factual record of work performed and the primary input for costs. It doesn't change a task's progress, which only changes with a progress report.

What it is used for: - Tracking the true amount of work performed. - Providing the data for real-time cost calculations. - Comparing the effort spent with the estimated effort.

How to Enter Actual Effort

Team members can report their effort using two different methods, depending on their needs.

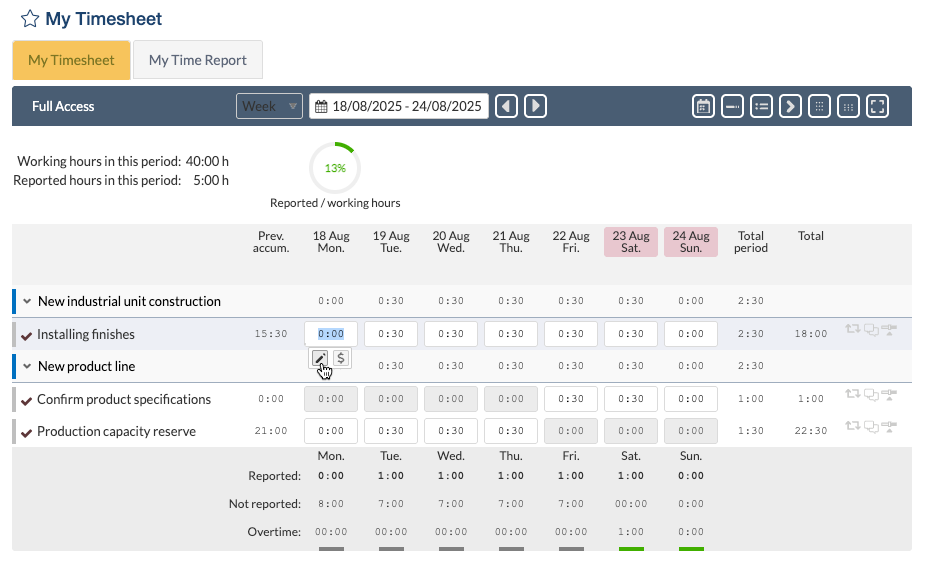

a. From the ‘My Timesheet’ Tab: The primary method for reporting effort is through the Timesheet, located under ‘My Desktop’ section.

This provides a grid view where users can efficiently enter the number of hours worked against multiple tasks for each day of the week. It is ideal for bulk time entry. Here’s how to use it:

  1. Go to My Desktop > My Timesheet.
  2. This opens a grid view of your assigned tasks for the week.
  3. Find the task you want to report time for.
  4. In that task's row, enter the hours you worked in the column for the correct day.
  5. Repeat for any other tasks.
  6. Save your timesheet.

b. From the ‘My Tasks and Activities’ Tab: Team members can also report effort from their ‘My Tasks and Activities’ tab, found under the ‘My Desktop’ section.

Clicking the time entry icon for a task lets them input hours with a specific start and end time, or across a date range. Here’s how it works:

  1. Go to My Desktop > My Tasks and Activities.
  2. Find the task you want to report time for.
  3. Click the time entry icon next to the task name.
  4. In the window that opens, enter your hours using a start/end time or a date range.
  5. Click Save.

Note: If you enter hours this way and later edit the total for that day on ‘My Timesheet’, the detailed start and end times will be lost.

Who can edit Actual Effort? Team members have full control over their own time entries for any open reporting period. It is important to note that managers cannot directly enter or modify another user's Reported Effort in their timesheet. This ensures that the reported hours are an accurate reflection of the work performed by each individual.

4. Accepted Effort

Accepted Effort is the official, finalized amount of effort that is used for financial reporting and cost consolidation. It is the value that the organization formally recognizes.

By default, Accepted Effort is the same as Actual Effort, meaning it directly reflects the hours reported by team members in their timesheets. In most cases, Accepted Effort is left unchanged.

When a manager overwrites the effort, they are setting a single, total value for the entire task-user assignment, not editing the day-by-day entries. For example, if a user reports 25 hours but the budget is capped at 20, the manager can set the Accepted Effort to 20.

What it is used for: - Finalizing costs for a given period. - In projects, it allows managers to override the actual hours for budgetary or billing purposes.

Who can edit Accepted Effort? The ability to edit Accepted Effort is the main difference in how effort is managed between projects and services, and this is by design.

a. In Projects: The Project Manager can edit the Accepted Effort from the Team tab. Here’s how:

  • Go to the project and open the Team tab.
  • If the accepted figure (the last number in each cell) is not visible, enable Show accepted effort in the three-dot menu at the right of the header.

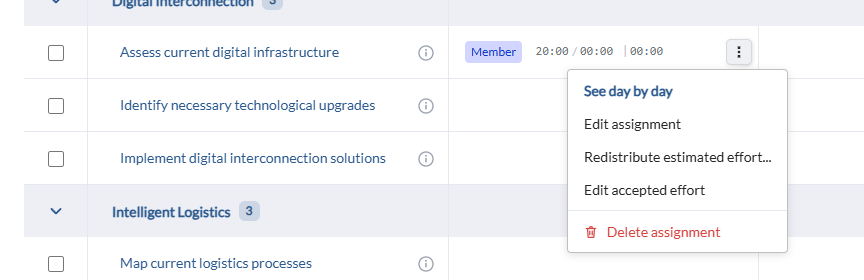

  • Open the three-dot menu of the assignment, select Edit accepted effort and enter the value.
  • Click Save.

A manually set value appears in bold with a pencil icon. To return to the automatic value, empty the field or select Reset to reported in the same menu. See Project team management.

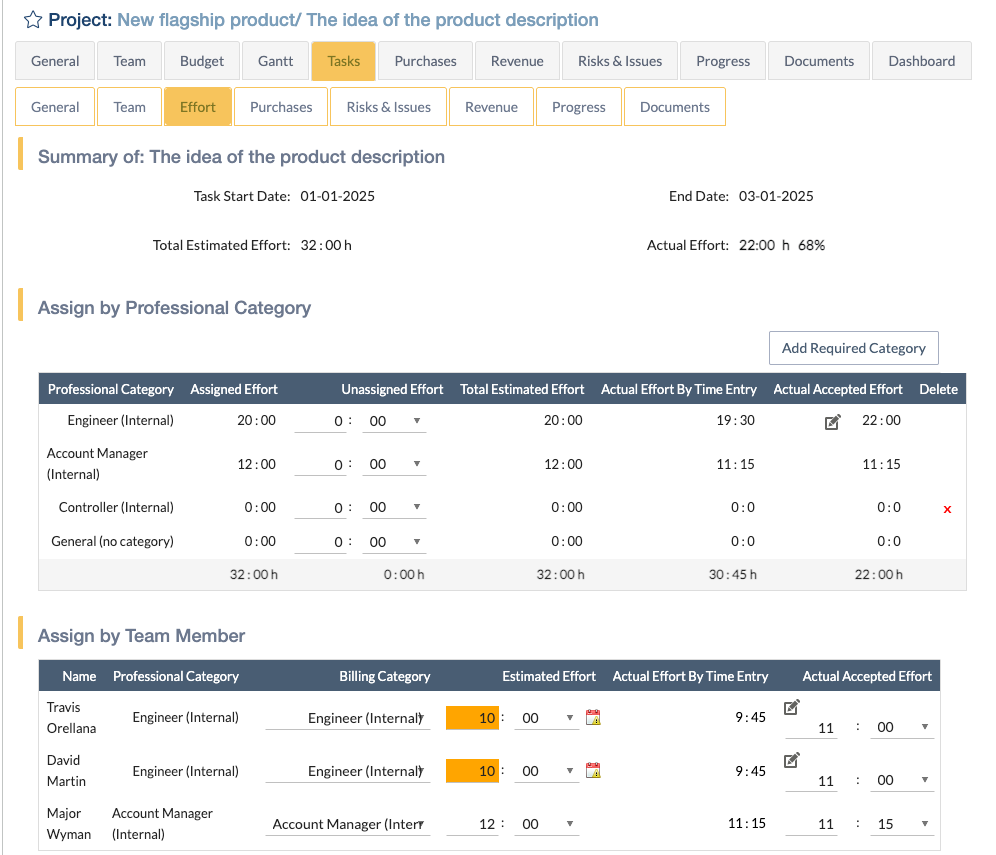

The task Effort tab also has an Accepted Effort field for each team member. There, leaving it empty, entering 0 or entering the reported value keeps it automatic.

b. In Services: Accepted Effort is not editable and will always reflect the total Reported Effort. This is by design to ensure an unaltered historical record for continuous activities.

Period End Close
