Waterfall Project Tracking

ITM Platform gives you the tools to report and monitor the progress of tasks in a project. Task progress will be used to compute the calculated progress of summary tasks and the project’s total progress.

Before continuing, let’s define two similar but not equal concepts:

  • Progress of a task, a summary, or a project (also referred to as percentage completed) is a percentage that represents the actual progress ratio. Thus, 0% will indicate that it has not been started, and, in general, 100% indicates it has been completed. You can mark tasks and projects as completed without reaching 100%.
  • Progress report of tasks and projects offers additional information. It includes an assessment (configurable values list), a description, the percentage completed (progress), and a progress report date.

The progress value represents real progress and is reported by a person, usually the task manager or the project manager.

Reporting hours doesn't change a task's progress. Hours entered in the timesheet record actual effort and cost, but a task's % completed only changes with a progress report, because the hours spent on a task don't necessarily reflect how much of it is done. This also applies when the project calculates progress by effort: that method uses estimated hours to weight each task in the summary and project progress, not the hours reported. See calculated progress.

Who can report the progress of a task?

These users can add a progress report to a task:

  • The task manager, who is a team member with the Manager task role.
  • The project manager, when their role allows progress reports.
  • Company administrators and users whose role gives access to task progress in all projects, such as Full Access users, without being assigned to the project.

Task members, assigned with the Member task role, report time on the task but can't report its progress. When they finish their part of the work, the task manager or the project manager updates the progress.

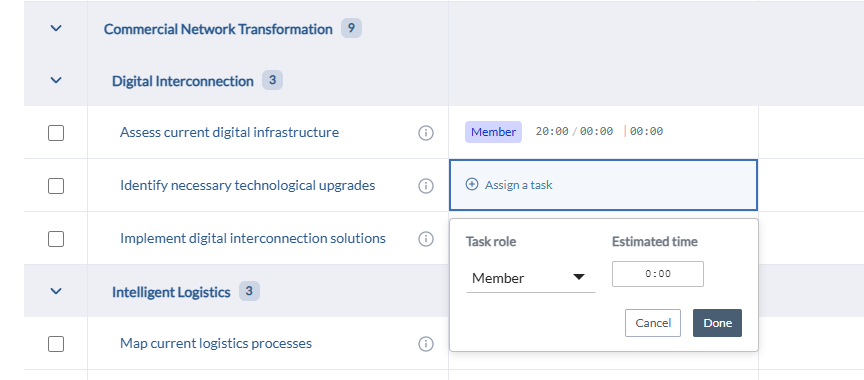

The task manager is chosen when the task is assigned in the project's Team tab, by selecting the Manager task role. See Project team management.

Where can you report progress on tasks?

There are three places from which a user can report progress: Timesheet, Task Tracking section, and the Gantt.

It is possible to track in an automated way from another application using the API .

Tracking from the timesheet

In the timesheet, the Add a progress report icon appears next to each task you manage, next to the tasks of projects you manage when your role allows progress reports, and next to every task if you are a company administrator. It opens the progress report form without leaving the timesheet, so you can record hours and progress in the same visit.

Tracking from the “Task” tab

The tasks have several sections of information, one of them being “Progress”, where you will see a tracking history as well as the possibility of adding a new one.

Progress Report from the Gantt chart

In the Gantt chart, there is a “% Completed” column that can be edited by the project manager.

When saving, a progress report will automatically be generated for each task. Progress of summary tasks will be updated following the calculated progress method configured in the project. If the option is checked, a project progress report will also be created.

Task status and progress

Progress report by changing the task status

When you move a task to a completed type of status, you can configure the system so that progress is increased to 100%, generating automatic progress report.

To configure this behavior in waterfall projects (Gantt), access the SETTINGS menu > PARAMETERS > Task Parameters > Task Status. When selecting “Status Type”, select the “Automatically update to 100%” checkbox

Thereafter, the tasks you mark as completed will be assigned 100% progress.

Note that if you roll back the status to a “Pending” or “In Progress” type, you will need to manually assign the new progress, if desired.

Task status changes with progress

The reverse also happens, and it needs no configuration: on waterfall projects the task status follows the progress you report, wherever you report it (the task’s Progress section, the Gantt chart, or the API).

  • Reporting any progress above 0% on a “Pending” task moves it to an “In Progress” status.
  • Reporting 100% moves it to a “Completed” status.
  • Lowering a completed task below 100% returns it to “In Progress”, and taking it back to 0% returns it to “Pending”.

When your organization has more than one status of a type, the default status of that type is used, and otherwise the oldest one. Tasks in “Backlog” or “Archive” keep their status unless they reach 100%, a status you set by hand stays until the next progress report, and agile board columns never change this way.

Progress Report section

In the Progress section of the project, you will have access to the following metrics:

  • % Completed: represents the progress created by the project manager, either manually or automatically.
  • % Expected today: represents the progress that the project should have reached today, based on its duration.
  • Baseline – % expected: represents the progress you would expect from the active baseline.

If you did not set a baseline, this data will not be reflected in any of the charts.

In this section you will also find:

  • “Add a progress report” button, the option to report progress manually
  • “View History” button, that allows you to access previous progress reports
  • “Description of current status” section shows last report description
  • The “Earned Value” button will show you the project’s Earned value analysis

FAQ - Frequently asked questions

Does reporting hours in the timesheet update the task's progress?

No. Hours record actual effort and cost, and the task's progress stays the same until someone adds a progress report. If you are the task manager, add it from the Add a progress report icon next to the task in the timesheet when you enter your hours. If you are a task member, ask the task manager or the project manager to update the progress.

Why doesn't the Gantt chart show progress after the team reported hours?

The Gantt chart's % Completed column shows each task's latest progress report, and summary tasks and the project are calculated from those values. Reported hours don't count toward that figure, even in projects that calculate progress by effort. To compare the hours spent with the hours estimated, look at the task's actual and estimated effort.
